Salt Lake City

MyStreet

Email: mystreet@slcgov.com

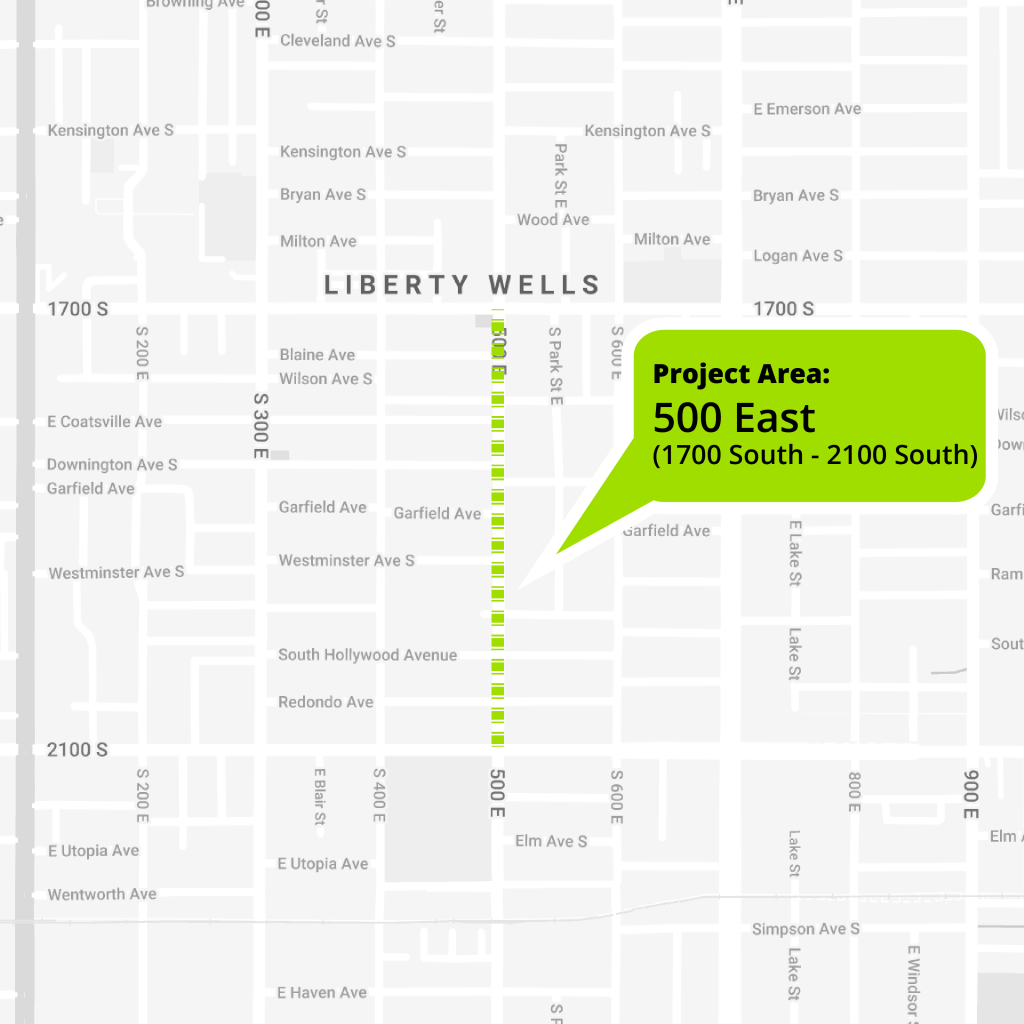

500 East: 1700 South to 2100 South

To be added to the project email list for design and construction updates, please email “updates” to 500East@slcgov.com.

This section of 500 East will be reconstructed in 2020.

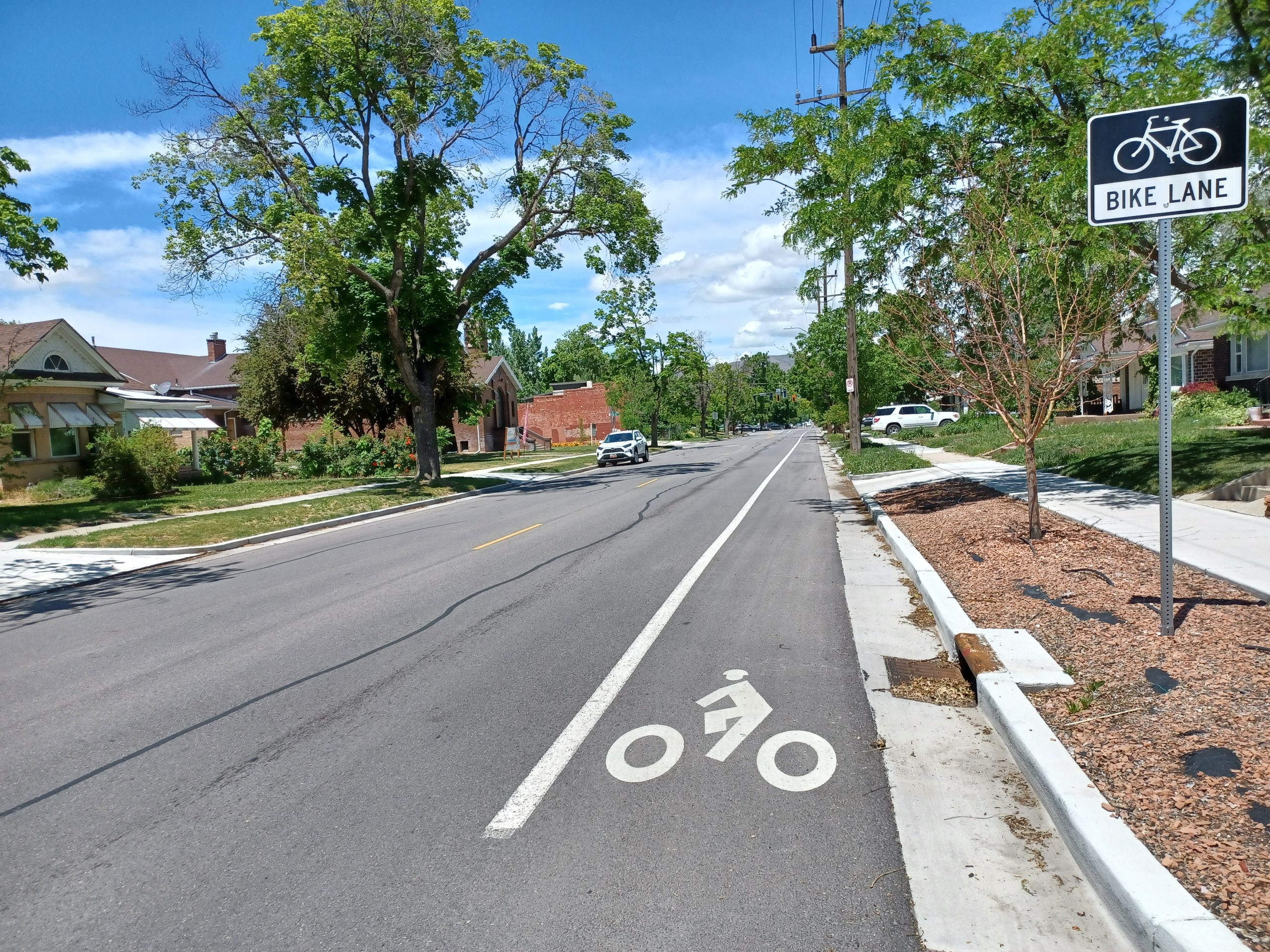

The pavement, sidewalks, and gutters will be fixed. A northbound bike lane will be added; bus stops consolidated and improved, and raised crosswalks will be added.

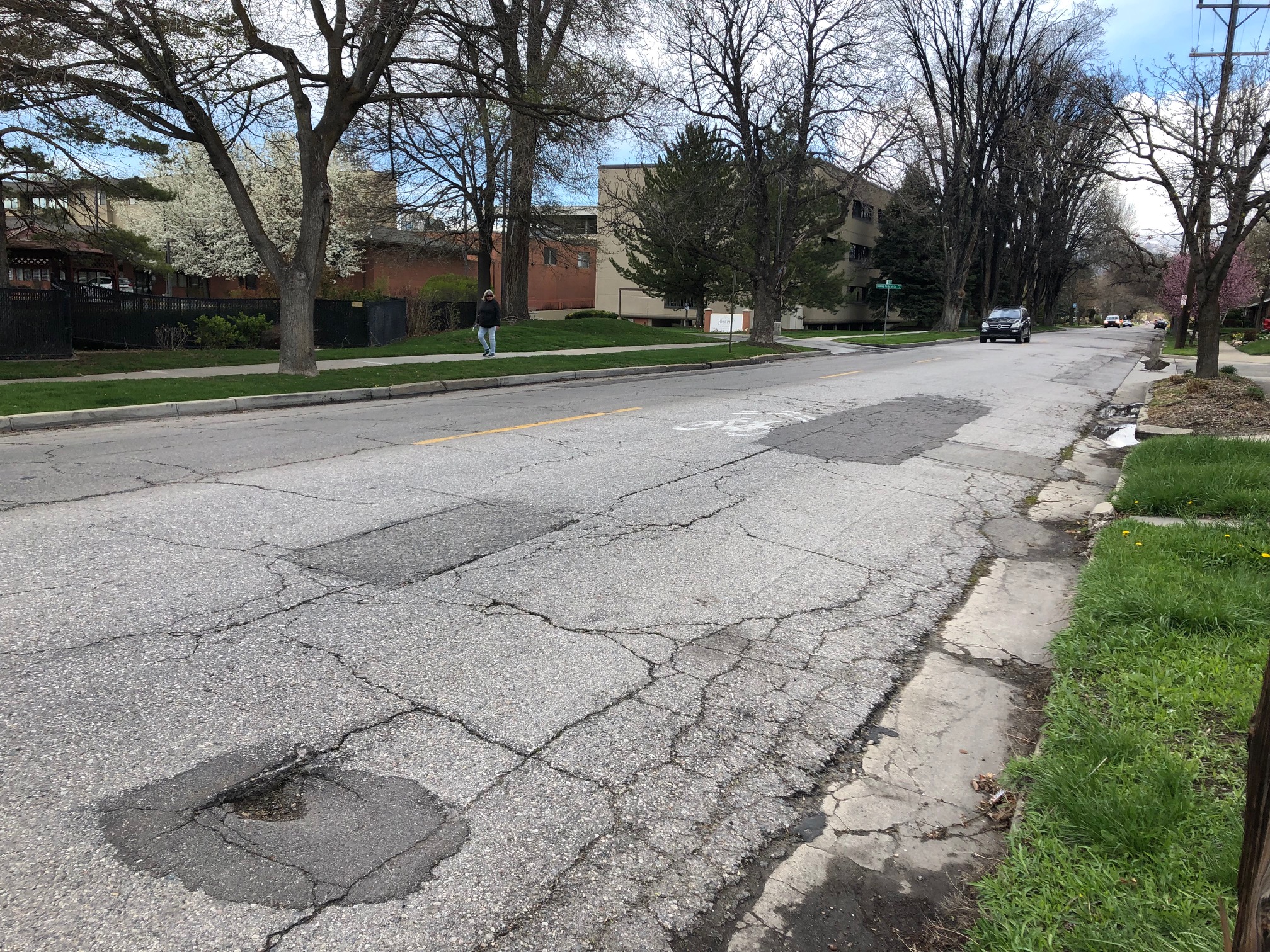

This image has an empty alt attribute; its file name is IMG_3735-1024x768.jpg

The final design is based on SLC’s Complete Streets Ordinance, master plans, technical analysis, and public input over the course of 2019. Salt Lake City will complete the design of this project in December 2019.


Check it out!

We are now approaching the final engineering design, in December 2019. You can see what will happen at specific locations along the street.

  • Engineering Drawings (final draft), simplified for public viewing.
    • Sidewalk sections to be replaced
    • Driveway approaches to be replaced
    • Location of 42″ aqueduct
    • Raised crosswalks
    • Bus stop concrete pads
  • Striping Drawings (final draft)
    • Pavement markings (bike symbols, stripes, etc.)
    • No parking locations
    • Bus shelters, benches, trash cans, etc.

Email us at 500East@slcgov.com or call 801-535-6251 if you have any questions.


Street Design

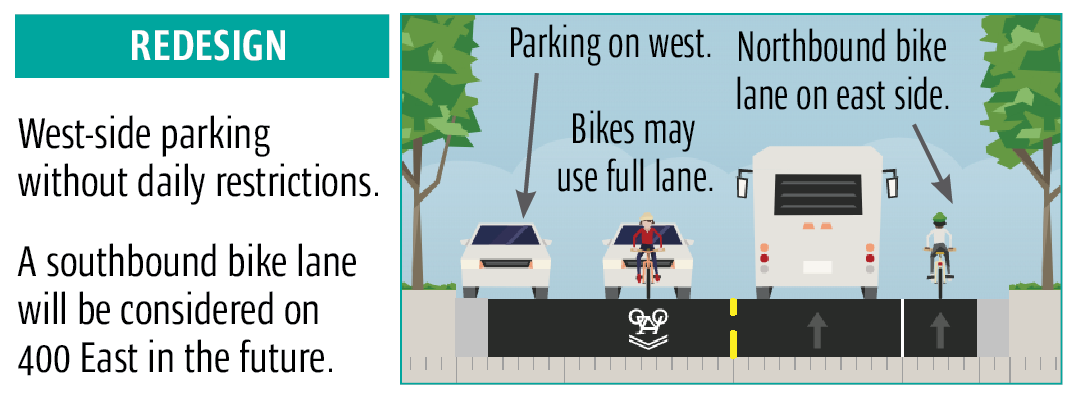

This is the same configuration as 500 East just to the north, between 1300 S and 1700 S.

Smoother gutters after the reconstruction will allow this to fit within the existing curbs.

Bus Stops

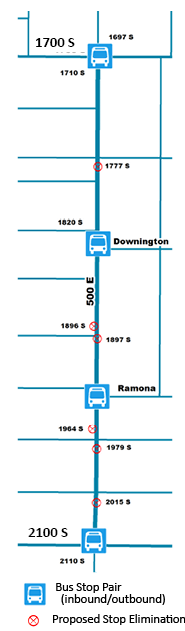

This image has an empty alt attribute; its file name is Picture1-2.png

Bus stops will be consolidated for faster service.

All stops will be made ADA accessible, with concrete pads and no curbside parking to block passengers from boarding.

All stops will receive shelters or benches. These drawings show which stops are getting what.

How long will your walk to a new bus stop be?  (try using Google walking directions if you’re not sure!)

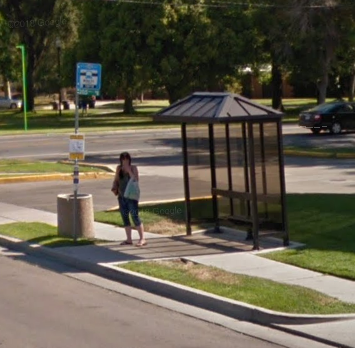

This image has an empty alt attribute; its file name is BusShelter500E-1.png

Raised Crosswalks

Raised, brick-look concrete crosswalks will link bus stop pairs across 500 East. The crosswalks will be designed for 30 mph travel, fire trucks, buses, and snowplows.

Unlike speed bumps, raised crosswalks are designed to be driven over without slowing — if you’re going the speed limit!

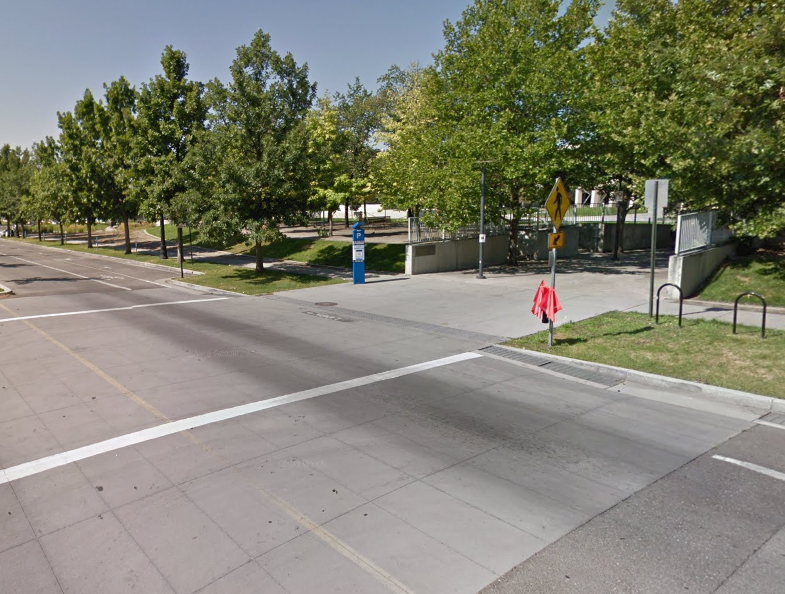

This image has an empty alt attribute; its file name is RaisedCrosswalk300E.png

Raised crosswalks received about 70% support from our survey participants who live on the street, live nearby, commute on the street, etc.  About 20% neutral, and around 10% strongly opposed – this same profile across demographics.


Keep in Touch: Further information on the construction timeline and impacts will be available on this webpage. Email “updates” to 500East@slcgov.com to request to be added to the project email list.


Project History & Timeline:

April – May
2019
Community input on current street design:
likes / dislikes and safety suggestions.
Read our report about what we heard.
See the raw data.
Spring 2019

Data collection / Complete Streets assessment.
Crash reports, parking use, traffic volumes, master plan recommendations.
May – June 2019Community input on conceptual design.
Read our report about what we heard.
See the raw data.
August 2019Final conceptual design announcement.
August– October 2019 Engineering drawings by City design team based on the conceptual design.
Late Fall 2019Final draft design available for viewing. See what the street will look like. (links at top of page)
December 2019Final design
January 2020Project out to bid
Spring 2020 – Summer 2021 -> WE ARE HERE <–
Construction*

What to expect during construction:

*Construction is anticipated to begin in Spring 2020, but the overall schedule is subject to change due to weather or unforeseen circumstances.

Access during construction

  • On-street parking will be restricted.
  • Traffic restricted to local access only.
  • 205 bus will be rerouted, likely to 400 East.
  • Access to drive approaches will be restricted for reconstruction and as the concrete cures.

Water and other utilities

  • Water main replaced; service disruptions will be noticed 48 hours in advance.
  • Aqueduct pipe placed from Downington to Coatsville, to be connected in a future year. This will prevent 500 East from being dug up again.
  • The storm drain on the northern part of 500 East will be replaced; curb and gutter will be repaired throughout the project to improve drainage.

Street trees

  • A few trees in poor health will be removed.
  • The replacement of trees and the planting of new ones will be conducted at the end of the project.
  • If you want a tree in the park strip in front of your home, please contact Urban Forestry: 801-972-7818 or urbanforestry@slcgov.com.

Funding Our Future

This project is part of the Funding Our Future streets reconstruction bond approved by voters in 2018.

Share "500 East: 1700 South to 2100 South" to your social network:
